The Marblehead Rail Trail draws walkers, dog owners, families, birders and a growing number of bike commuters. Many of them joined the same Zoom call Monday night to talk about what comes next.
About two dozen residents joined town staff and consultants on April 27 to review the final 25% design for two stretches of the trail. Discussion ranged across paving, plantings, signs, e-bikes, wildlife, wetlands and how much should change at all.

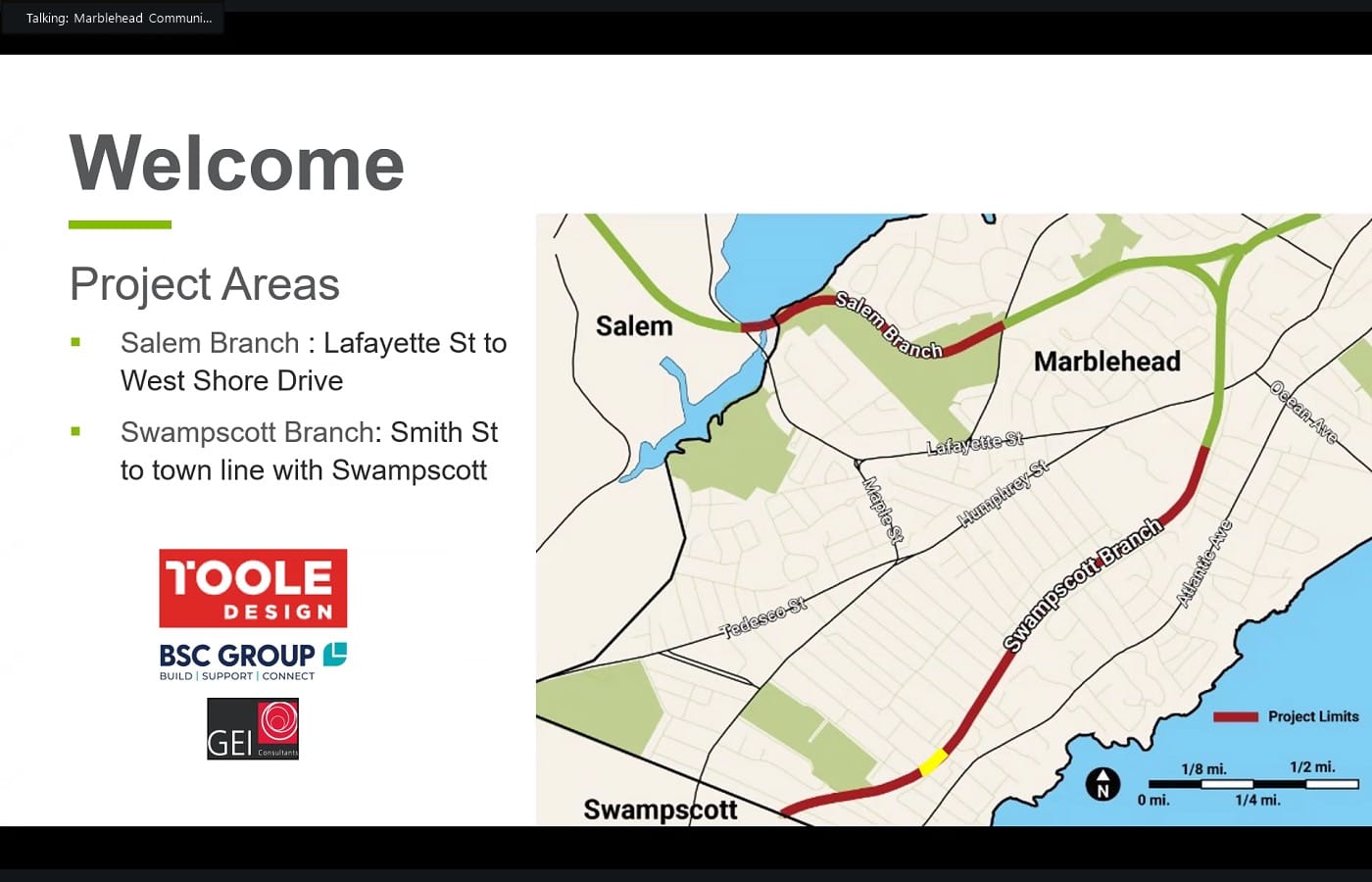

The project covers the Salem Branch from Lafayette Street to West Shore Drive, and the Swampscott Branch from Smith Street to the town line with Swampscott — part of the roughly 4.5-mile trail and its nine street crossings. The design team is led by Toole Design Group with sub-consultants BSC Group and GEI.

Brendan Callahan, the town’s director of community development and planning, walked through the timeline. The 75% design is expected by the end of May, 90% design between August and the end of 2026, and environmental permitting running through the end of the year. After that, the picture gets harder.
“We currently lack the funding for the 100% design phase,” Callahan said.
The earliest shovel-ready date would “maybe be spring of 2028,” he added, and only if the town secures outside money to finish design.
Kathleen Ogden Fasser, senior principal landscape architect at Toole Design, walked attendees through cross-section, planting, signage, drainage, trailheads and road crossings. Most of the trail will be stabilized aggregate, she said, with an 11 ft path, 2-3 ft shoulders, low-mow native seed mix in the swales, pollinator plantings and a deliberately spare approach to signs.
The plan reflects more than a year of public input, including a Dec. 9, 2024 meeting, stakeholder sessions, a site walk with the Marblehead Historical Commission and a public site walk in August.
Several residents praised what they saw. David Krathwohl welcomed efforts to save trees, minimize signage and preserve historical artifacts like the Clifton Station granite curb, the Ware Pond whistle post and a rail spike lodged in bedrock near the high school.
Dan Tucker, who began commuting by bike to Salem last fall, said he was “thrilled to see that the Salem branch will be paved.”

Brian Rooney, who takes his children to school on his e-bike, said he appreciates the planned upgrades from Smith Street to Pleasant Street.
The most sustained discussion centered on the proposal to pave the Salem Branch from Lafayette Street toward West Shore Drive. Fasser pointed to two factors.
The Marblehead Municipal Light Department has preliminary plans to bury electric lines through the corridor and would need manholes set into the path; patching asphalt around manholes within a stabilized-aggregate trail creates erosion at the seams.
Long stretches of the Salem Branch also run within about 10 ft of mapped wetlands, and stabilized aggregate cannot tolerate prolonged saturation.
For abutters who walk the trail daily, those reasons did not feel like enough. Jessica Thibodeau, who lives steps from the corridor, said the trail is part of her family’s daily life — dogs, kids, turtles, ducks.
“There’s no way you could pave and not disrupt that ecosystem,” she said.
Another household member said the wetlands sit “at most eight feet” from the trail in places. Krathwohl asked whether asphalt islands around the manholes might work instead.
“I think paving that section is really just completely counter to that, and really needs to be reconsidered,” he said.
Don Morgan said the design has grown more elaborate over time, drifting from the lighter touch of the 2020 trail plan toward more concrete pads, bike repair stations and signage.
“I would like to see that dial turned back, I don’t know, 60% from where it is now, take some of that stuff out,” he said.
Fasser said the project will go before the Marblehead Conservation Commission as part of environmental permitting, with BSC Group leading that work. A representative joined one site walk, she said, though formal review has not yet begun. Several residents urged that it begin sooner.
E-bike speeds came up repeatedly, with several speakers careful to distinguish between everyday riders and a smaller share of users going too fast. Fasser said design alone cannot govern behavior on the trail; enforcement falls to the town. Callahan acknowledged the issue is a recurring one, citing outreach by the police chief and the Traffic Safety Advisory Committee.
Other concerns raised included long-term maintenance funding, abutter notification and the closing of some informal access points to control erosion. The metal-plate bridge crossing at West Shore Drive is outside the current funded scope, Callahan said, and the town is looking for money to design a fix.
The trail has been selected as one of 10 signature trails for the 2026 MassTrails 10 campaign.
Chat comments will be folded into meeting notes, officials said, and the presentation will be posted on the town website. More input is expected as design and permitting continue through the year.
